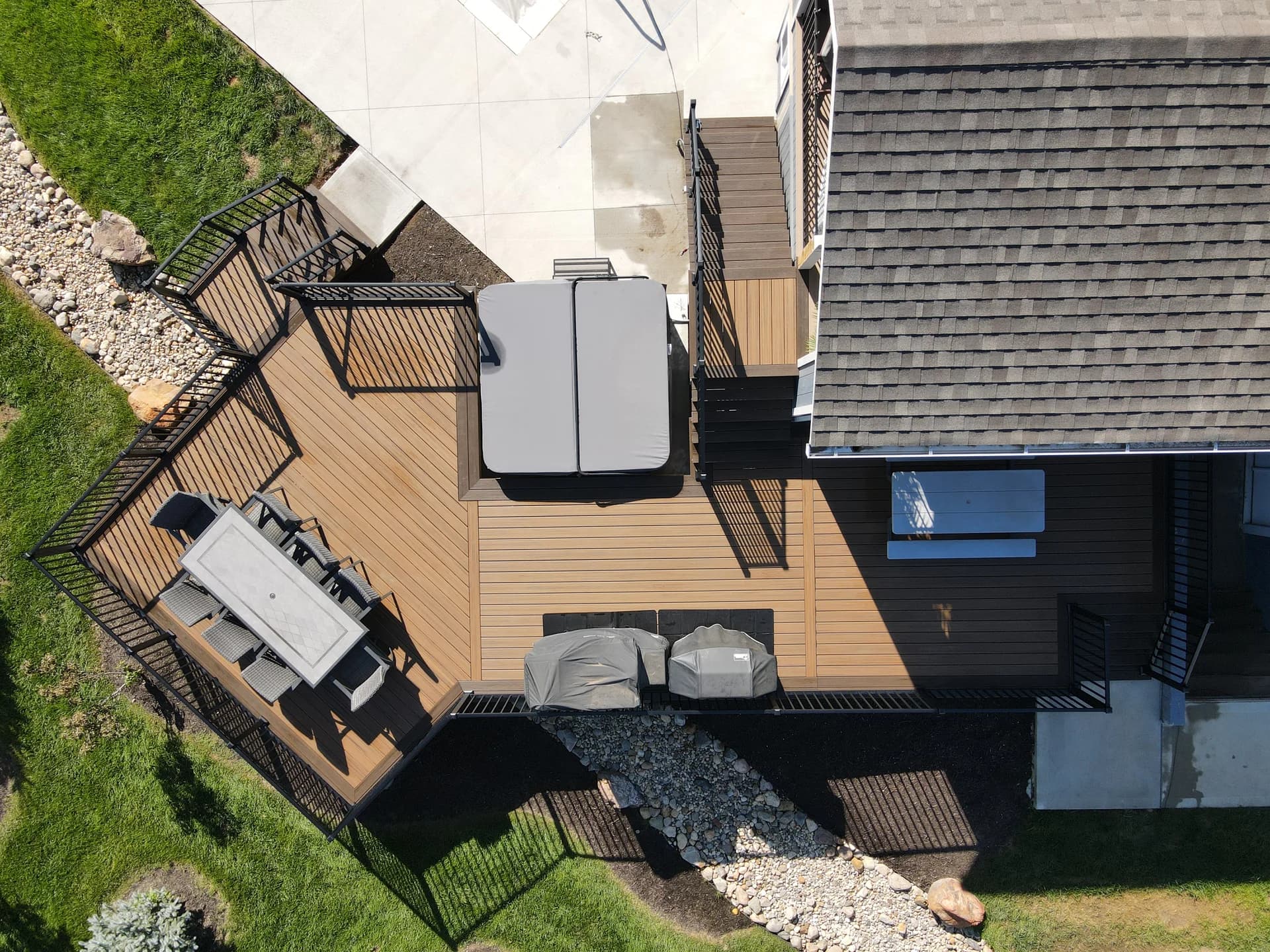

North Texas is one of the most HOA-dense markets in the country. According to the Foundation for Community Association Research, Texas has more HOA-governed communities than any other state. In planned communities across Rockwall, Wylie, McKinney, Heath, and Forney, virtually every exterior modification — fence, deck, pergola, patio cover, even a storage shed — requires Architectural Control Committee (ACC) approval before construction begins. Here's what homeowners need to know to navigate the process without expensive delays or mandatory demolitions.
Why HOA Approval Matters More Than the City Permit
Most homeowners understand that city building permits are required. Fewer realize that HOA approval is a completely separate process that must happen first — and that it can take longer, require more documentation, and result in stricter requirements than the city permit.
Building without HOA approval — even if the city permit is in hand — exposes you to HOA fines (often $50–$200 per day), mandatory stop-work orders, and potentially a requirement to demolish or modify the structure at your expense. We've seen homeowners spend $4,000–$8,000 modifying a fence or deck post-construction because they skipped or rushed the HOA process.
The Typical ACC Review Process in DFW Communities
Most HOA architectural review committees in DFW operate on a 30–45 day review cycle, though some communities expedite smaller projects within 2 weeks and others take up to 90 days for complex structures. The process typically works like this:
- 1.Homeowner (or contractor) submits application form + required documents to the ACC or community management company
- 2.Application is reviewed at the next scheduled ACC meeting (often monthly) or passed to a subcommittee
- 3.ACC approves, requests modifications, or denies with written explanation
- 4.If modifications are required, revised documents are submitted and the review cycle restarts
- 5.Approval is issued with any conditions (specific stain color, setback compliance, etc.)
- 6.Construction can begin — typically after city permits are also secured
Communities we regularly work in — including Stonebridge Ranch in McKinney, Travis Ranch in Forney, Buffalo Creek in Royse City, Woodcreek in Fate, and various Rockwall subdivisions — all have slightly different processes and documentation requirements. Understanding the specific HOA before submitting saves weeks.
What HOAs Review for Fences
Fence approvals are the most common ACC submission we handle. Here's what most DFW HOAs restrict:
- —Height: Almost universally 6 feet maximum for side and back yards. Some HOAs require 4 feet maximum in front yard or corner lot side yards facing a street.
- —Material: Cedar is universally accepted. Some HOAs prohibit chain link entirely. Many prohibit pressure-treated pine for visible fence sections. Composite and vinyl are accepted in some communities and restricted in others.
- —Style: Shadowbox (alternating pickets) and board-on-board are widely accepted. Horizontal slat fencing is restricted or prohibited by many older HOAs — newer communities more often allow it. Picket fences are typically unrestricted.
- —Color: Most HOAs require natural wood tones. Painted fences (white, gray, black) are allowed in some communities and prohibited in others. High-gloss finishes are often restricted.
- —Setbacks: Many HOAs require fences to be set back 18–36 inches from the front of the house and from property corners — separate from city setback requirements.
- —Line of sight: Corner lots often have additional restrictions to maintain visibility at intersections.
What HOAs Review for Decks and Patio Covers
Free Estimate
Planning this type of project?
Tell us your scope, city, and timeline. We follow up with clear pricing and next steps — no obligation.
Deck and patio cover submissions are more complex than fence submissions because they involve structural elements, elevation drawings, and sometimes engineering calculations. Common HOA restrictions for decks:
- —Setbacks: Decks must typically maintain the same rear and side setbacks as the house structure — usually 5–10 feet from property lines depending on the community.
- —Height: Elevated decks above a certain height (often 30 inches above grade) require additional documentation and sometimes engineering review.
- —Railing style: Many HOAs specify that railings must complement the house architecture. Cable railing and horizontal bar railing are restricted in some traditional-style communities.
- —Materials: Composite decking is widely accepted and often preferred by HOAs because of the lower maintenance appearance. Pressure-treated lumber is accepted but sometimes restricted to ground-level applications.
- —Roofed structures: Pergolas and patio covers that attach to the house typically require the roofline to match or complement the existing roof. Metal roofing on patio covers is sometimes restricted in residential HOAs.
- —Lighting: Some HOAs restrict exterior lighting that may be visible to neighbors or cause light pollution.
What We Include in Our HOA Submission Packets
We handle HOA submissions on behalf of our clients for all projects. Our submission packet typically includes: a site plan showing the structure's location on the lot with dimensions and setbacks from property lines; elevation drawings showing the structure's appearance from each relevant side; a material specification sheet with product names, grades, colors, and finish types; photos of similar completed projects for reference; and a cover letter addressing any specific HOA restrictions we anticipate questions about.
This level of documentation — which exceeds what many contractors provide — results in a significantly higher first-submission approval rate. Incomplete submissions that go back for more information reset the review timeline and add 30–60 days. We've never had a client required to tear down a structure because of HOA non-compliance.
Most Common Reasons for ACC Rejection (and How to Avoid Them)
| Rejection Reason | How to Avoid It |
|---|---|
| Incomplete application | Submit all required forms, site plans, and material specs together |
| Non-approved material | Verify material list against HOA documents before specifying |
| Setback violation | Measure and confirm setbacks from property survey or plat before submitting |
| Height exceeds limit | Confirm HOA height limit — it may differ from city code |
| Fence style not permitted | Review HOA CC&Rs specifically for style restrictions, not just height |
| Missing contractor license info | Include contractor license number and insurance certificate with submission |
We handle HOA submissions — you don't have to
For every project we build in an HOA community, we prepare and submit the full design packet, communicate with the ACC directly, and handle any revision requests. You focus on getting excited about the project.
Frequently Asked Questions
Common questions about this topic from DFW homeowners and project planners.
How long does HOA approval take for a fence or deck in DFW?
Most DFW HOA architectural committees review submissions on a monthly cycle, so approval timelines range from 2 weeks (expedited in some communities) to 45–60 days for standard review. If the first submission comes back with change requests, add another review cycle. We account for HOA review time in every project timeline and start the submission process as early as possible.
Can I start construction while the HOA reviews my application?
No. Building before HOA approval is approved can result in daily fines and mandatory removal orders — regardless of whether your city permit was properly issued. The HOA approval must be in hand before construction begins. Some communities allow you to pull city permits during the HOA review period, which is fine — you just can't break ground.
What happens if I build without HOA approval?
The HOA can issue violation notices and daily fines (typically $50–$200/day), issue a mandatory stop-work order, and require you to modify or remove the structure at your expense. In extreme cases, non-compliance can result in the HOA placing a lien on the property. The cost of getting approval first is always less than the cost of retrofitting compliance.
Are horizontal slat fences allowed in North Texas HOAs?
It depends on the HOA and when the community's CC&Rs were written. Many older DFW HOAs (pre-2010) have fence style language that only contemplates traditional vertical picket styles and may explicitly or implicitly prohibit horizontal designs. Newer planned communities more frequently allow horizontal slat fencing. We review each HOA's governing documents before specifying any fence style.
Do pergolas and patio covers require HOA approval?
Yes, in virtually all HOA communities. Any structure that adds to or modifies the exterior appearance of a property — including freestanding pergolas, attached patio covers, and screen enclosures — requires ACC approval in HOA communities. Even landscaping changes sometimes require approval in communities with active ACC boards.
